Project update

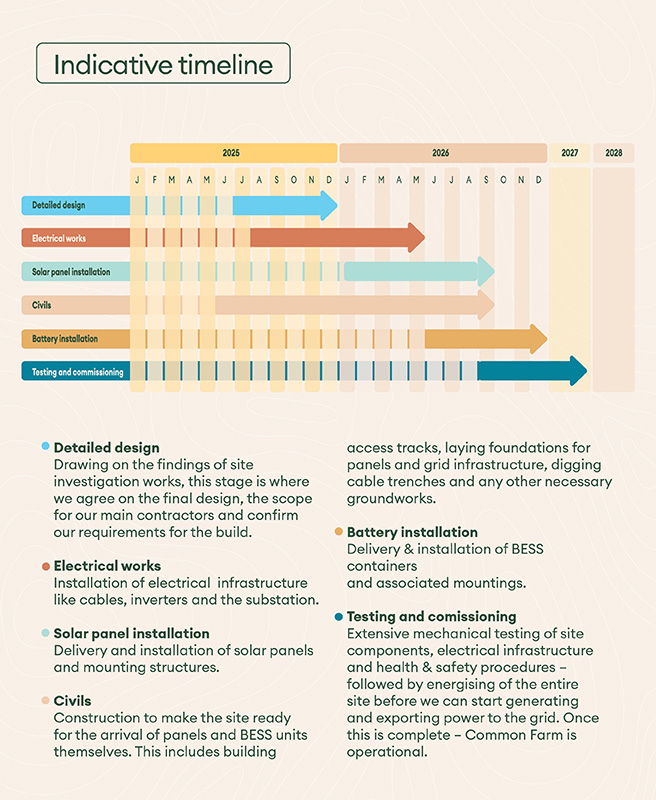

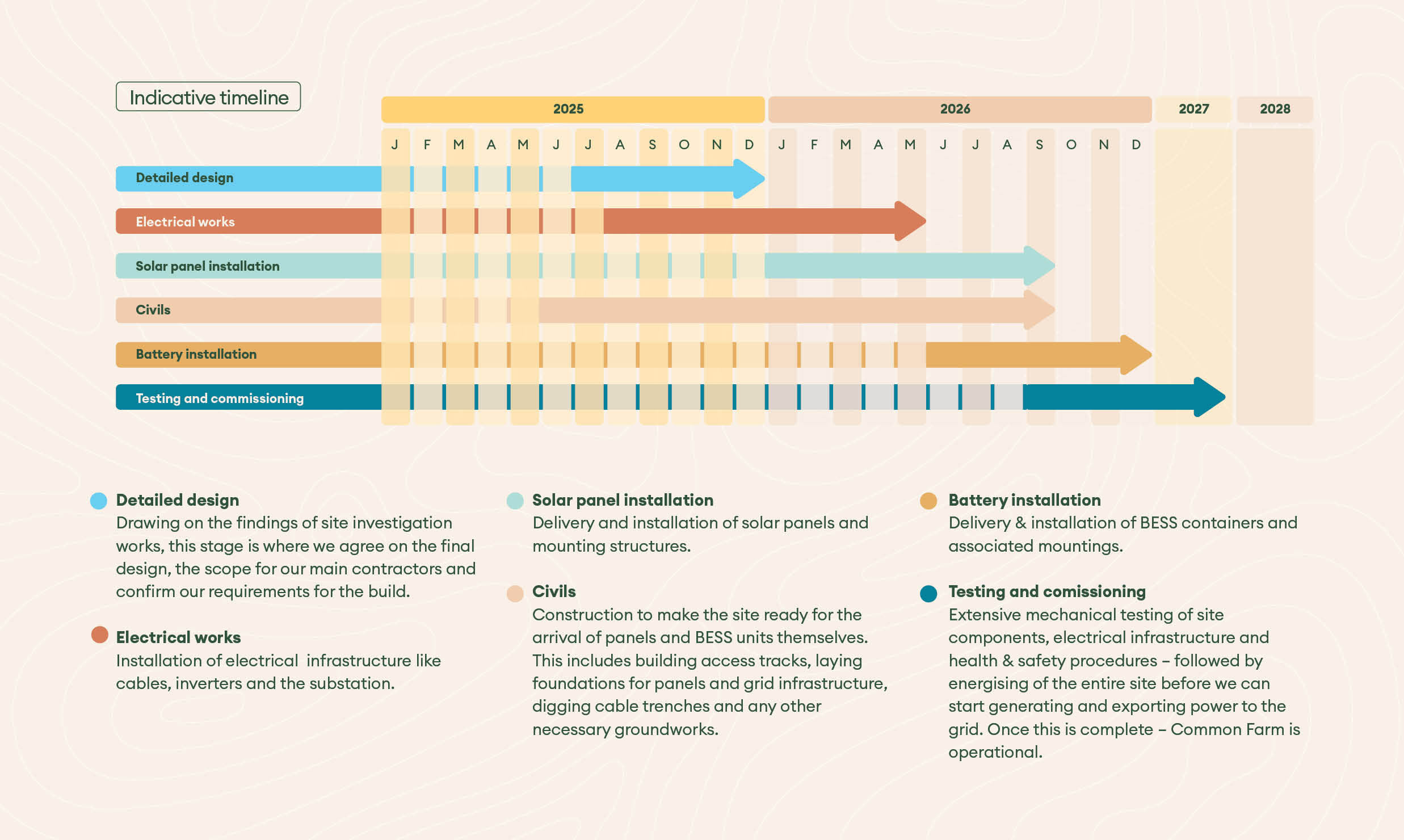

Where are we today?
OnPath Energy is working with market-leading independent connection specialist TMS Grid the new substation that will deliver the connectivity infrastructure for Common Farm and Northern Powergrid.

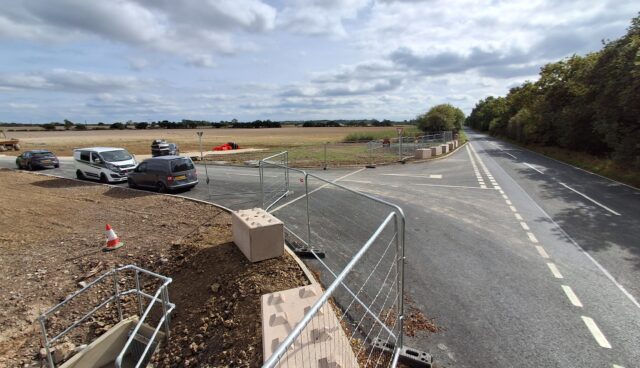

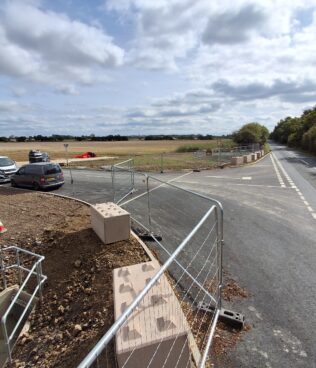

Work on levelling and preparing the 2,500 square metre substation site is underway, with construction expected to start around the end of 2025.
Construction work is expected to begin over the winter, with specialist infrastructure consultancy AECOM acting as lead consultant for the scheme.

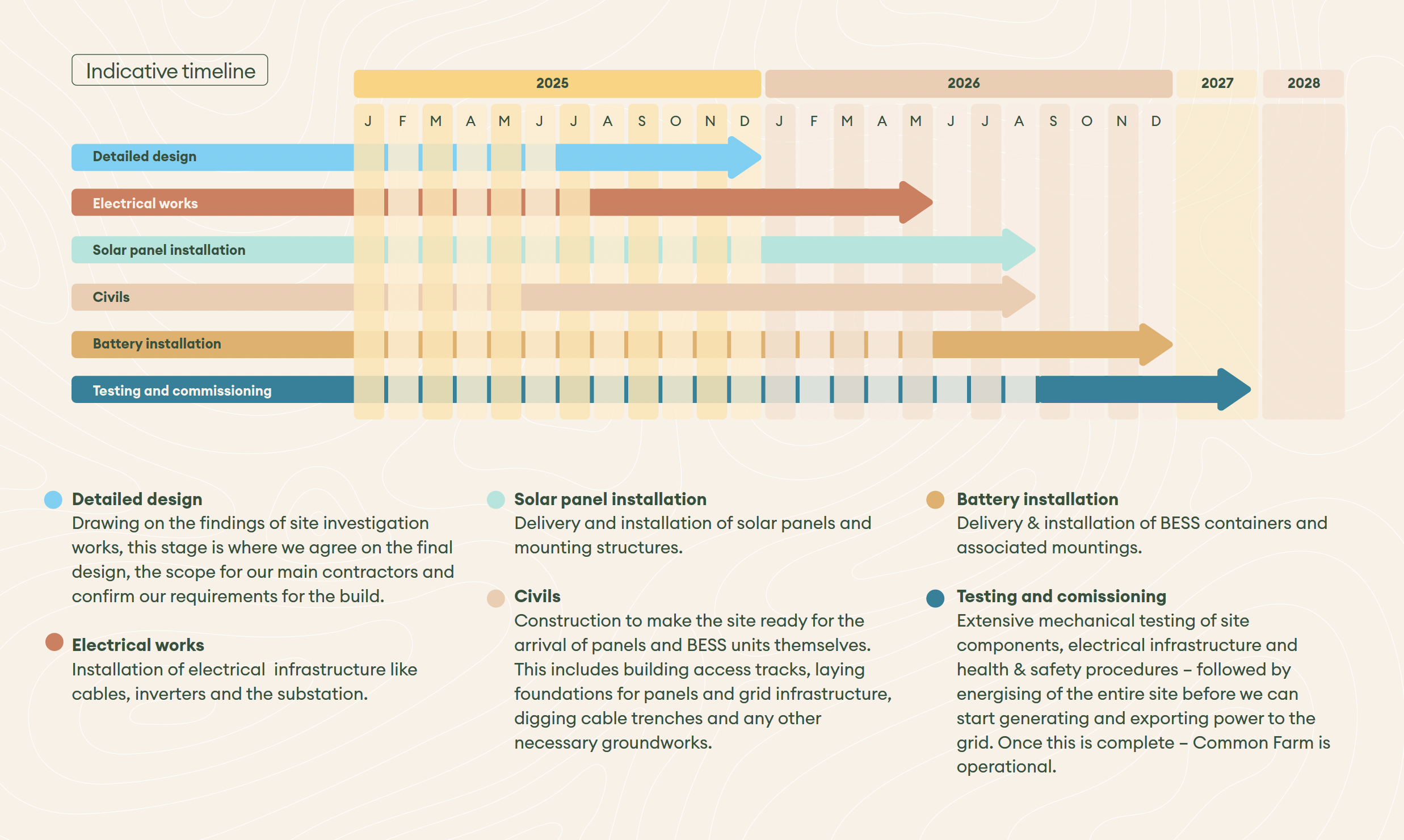

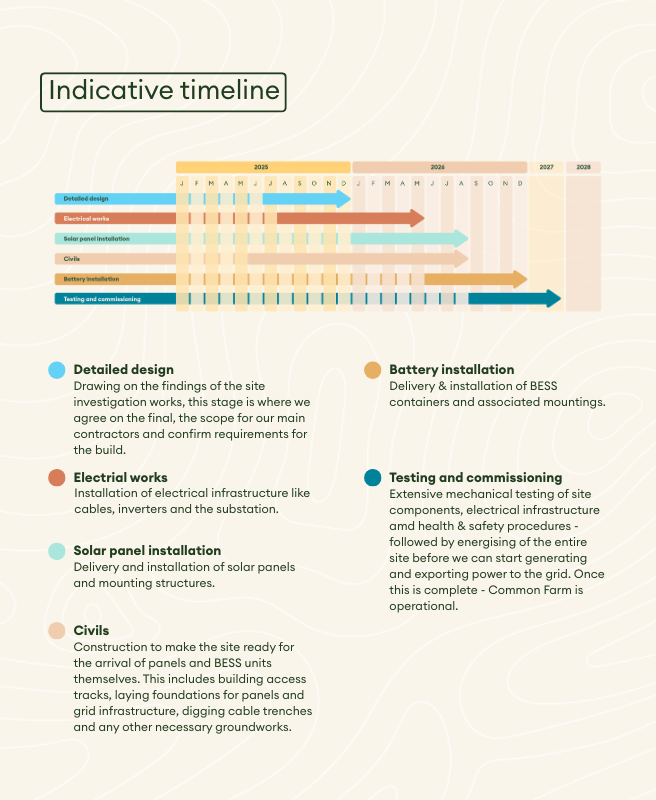

It is scheduled to be complete mid-2027, with the build set to provide a range of opportunities for regional subcontractors and suppliers through the development period in line with our OnPath Together development approach.
